Custom software development costs range from $25,000 for a focused MVP to over $500,000 for an enterprise-grade platform. The number on any proposal you receive is not arbitrary it is a product of five variables: project scope, team location, seniority mix, number of integrations, and how well requirements were defined before the first sprint began.
This guide breaks down what custom software actually costs in 2026 by project type, development phase, and region. It also covers the hidden costs that routinely catch companies off guard, and how nearshore delivery through Bluelight changes the cost structure across every tier.
According to a 2026 survey by GoodFirms, custom software development costs range between $30,000 and $200,000 for most projects, with nearly 66% of companies falling in the $30,000–$100,000 range for small and medium builds. Clutch's 2025 data puts the average project at $132,480 taking approximately 13 months to complete a figure that reflects the full portfolio, not just MVPs.
Custom Enterprise Software Development: What Drives the Cost Up
Enterprise builds consistently land at the top of every cost tier for three compounding reasons.
Compliance requirements. SOC 2, HIPAA, PCI-DSS, and GDPR are not features you add at the end, they are architectural constraints that shape every decision from data model design to access control to audit logging. Building compliance from sprint one costs less than retrofitting it after launch, but it adds 20–35% to scope regardless.
Complex integrations. Enterprise environments run on CRMs, ERPs, data warehouses, and legacy systems with proprietary APIs. Each integration adds scope, testing surface, and ongoing maintenance cost. A platform with six or more integrations is not six times harder to build, it is exponentially harder to keep synchronized as third-party APIs change.
Role-based access and audit trails. Enterprise products serve multiple user types with different permissions, data visibility, and workflow paths. Every role adds test cases, UI states, and backend logic. Audit trails who accessed what, when, and what they changed, require dedicated infrastructure that most MVP-tier builds skip entirely.
These three factors are why the same feature set costs three to four times more to build for an enterprise context than for a consumer product. A custom enterprise software development engagement requires thorough discovery before any cost estimate is reliable.
Custom Software Development Hourly Rates by Region 2026
Team location is the single most controllable cost variable. A US senior developer billing at $180–$280 per hour produces the same output as a Bluelight LATAM senior developer billing at $55–$80 per hour. The architecture, the code quality, and the delivery process are equivalent. The invoice is not.

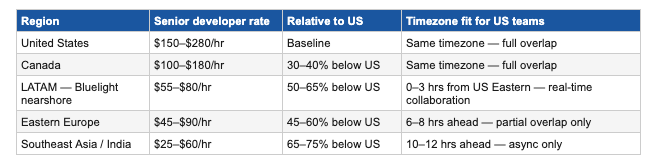

%203.43.28%E2%80%AFp.%E2%80%AFm..png)
The offshore rate looks attractive until you account for the coordination overhead. A Bluelight benchmark study shows that a single feature change request takes 48.5 elapsed hours with an offshore team in India versus 8 elapsed hours with a nearshore LATAM team a difference driven entirely by the 10.5-hour timezone gap. The offshore model costs only 2.8% less in direct spend but takes 84% longer to complete.
Custom Software Cost Breakdown by Development Phase
These percentages hold across project tiers, what changes is the absolute dollar amount, not the relative split.

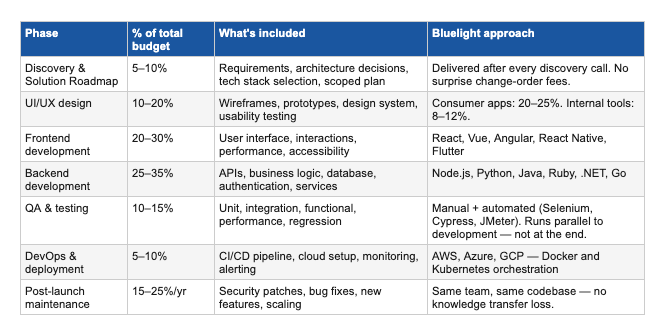

%203.44.12%E2%80%AFp.%E2%80%AFm..png)
Skipping QA to save money is one of the most reliably expensive decisions in software development. Research cited by ssntpl.com shows only 52% of software projects pass quality tests after release, and 29% of all failures are specifically due to inadequate testing. Proper QA costs 10–15% of the development budget. Fixing production bugs and managing customer churn costs significantly more.
Hidden Costs Most Estimates Do Not Include
The build cost is what vendors quote. The total cost of ownership is what you actually pay. These four categories routinely surprise buyers who focus only on the initial development invoice.
1. Annual maintenance and support
Custom software does not end at launch. Expect to budget 15–25% of the original build cost annually for security patches, bug fixes, dependency updates, and new feature development. A $200,000 build carries approximately $30,000–$50,000 in annual maintenance costs, according to ADEVS' 2026 custom software cost report.
2. Cloud infrastructure and hosting
Cloud costs scale with usage and are almost always underestimated at project start. A product serving 1,000 users might cost $500/month to host. At 50,000 users, that same architecture often costs $8,000–$15,000/month without active optimization. Serverless and cloud-native architectures can reduce this but require upfront design investment.
3. Third-party integrations and API fees
Most modern applications depend on external services payment processors, mapping APIs, communication platforms, analytics tools. Each carries ongoing fees. Stripe charges 2.9% + $0.30 per transaction. Twilio SMS costs fraction-of-a-cent per message at scale. These costs compound with user growth and are rarely included in development proposals.
4. Scope ambiguity premium
Over 52.7% of software projects exceed their original budget by at least 89%, according to data cited in ssntpl.com's 2026 cost analysis. The primary driver is not technology it is scope ambiguity at project start. Projects where clients arrive with clear workflow descriptions, defined user roles, and documented data flows run 25–40% cheaper than projects where discovery happens during development. Rework costs 3–5x more than building it right the first time.
Bluelight delivers a Solution Roadmap after every discovery call, a scoped plan with a predictable budget and no surprise change-order fees. See how the scoping process works → bluelight.co/contact-us
Fixed Price vs Time-and-Materials: Which Model Fits Your Project
The contract model you choose with your development partner determines who carries the scope risk, and how much you pay for it.

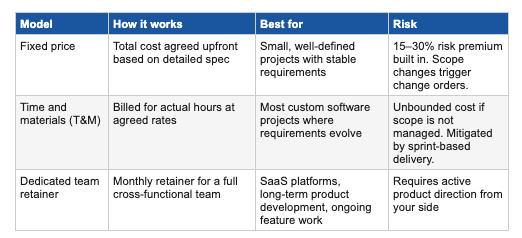

%203.44.45%E2%80%AFp.%E2%80%AFm..png)
Fixed-price contracts include a 15–30% risk premium that vendors build in to cover scope uncertainty they absorb on your behalf, according to Cozcore's 2026 pricing analysis. For most software projects, where requirements evolve as stakeholders see working software, time-and-materials with sprint-based delivery provides better value because there is no risk premium and the team can adapt without commercial friction.
How Software Development Outsourcing to LATAM Changes the Cost Structure
Software development outsourcing to LATAM changes the cost equation beyond the hourly rate differential, the savings compound across the entire delivery cycle.
The hourly rate gap is real. But the deeper savings come from timezone alignment specifically, from how quickly decisions close, feedback lands, and blockers get resolved when your team and their team are working at the same time.

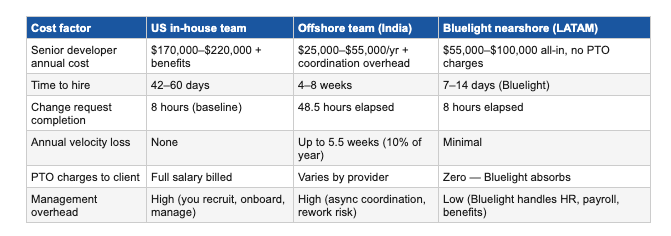

%203.45.09%E2%80%AFp.%E2%80%AFm..png)
Bluelight's published nearshore vs offshore benchmark demonstrates that nearshore LATAM teams complete change requests 84% faster than offshore teams and generate 7% higher project ROI — at only 2.8% more in direct engineering spend. Offshore invoices show a lower rate. They do not show the 48.5-hour feature request cycle, the 5.5 weeks of annual velocity loss, or the rework that compounds when blockers surface 12 hours late.
How Bluelight Delivers Custom Software Development Services
Bluelight delivers custom software development services through two models: nearshore staff augmentation that places vetted LATAM engineers into your existing team, and dedicated development teams that provide a full cross-functional squad including a Project Manager. Both draw from the same top-1% talent pool.
Every engagement starts with a Solution Roadmap a scoped plan with a predictable budget delivered after the discovery call. Development runs on 2-week Agile sprints with bi-weekly demos and daily timesheets tracked transparently in Toggl. Engineers are onboarded in 7–14 business days. Every engagement includes a 2-week risk-free trial.
Bluelight has delivered 1,250+ projects across SaaS, FinTech, Healthcare, E-commerce, and Enterprise at a 96% client retention rate, and was named to the Clutch 100 in 2026. For custom software cost ranges in Latin America by role and seniority, see Bluelight's complete nearshore software development rates guide.
"Working with them has been great. Bluelight has by far the most proactive communication and quality of output. They delivered quality code after each sprint, met the deadline, and generally impressed us."
— Dallas Heliker, CEO, Deniro Marketing
"From start to finish, their team was proactive, detail-oriented and focused on delivering value to our projects."
— Rodrigo Morales, MGM Resorts International
Frequently Asked Questions
How much does custom software development cost?
Custom software development costs range from $25,000 for a focused MVP to $500,000+ for an enterprise-grade platform in 2026. The five primary cost drivers are project scope, team location, seniority mix, number of integrations, and how clearly requirements are defined before development begins. Nearshore LATAM teams deliver the same output at 50–65% below US senior rates.
What is the cheapest way to build custom software?
The cheapest way to build custom software is to define requirements thoroughly before development begins, build an MVP with ruthless scope discipline rather than a full product, and use nearshore staff augmentation in Latin America for senior engineers at $55–$80 per hour with full US timezone alignment, rather than offshore teams whose coordination overhead eliminates most of the rate savings.
How long does custom software development take?
Custom software development timelines range from 6–10 weeks for a simple MVP to 8–18 months for a full enterprise platform. Timeline is driven by project complexity, number of integrations, compliance requirements, and team size. Sprint-based delivery with a nearshore team provides bi-weekly working demos so you see progress throughout not just at the end.
Is custom software development worth it?
Custom software development is worth it when your workflow is specialized enough that off-the-shelf SaaS requires major workarounds, when scaling costs on a per-seat SaaS license outpace a one-time build investment, or when data sovereignty, compliance, or competitive differentiation require software your competitors cannot replicate by buying the same tool.
Key Takeaways
- Custom software costs $25,000–$500,000+ in 2026, depending on project complexity, team location, seniority mix, and how clearly requirements are defined before development begins.
- Team location is the single most controllable cost variable. Bluelight's nearshore LATAM engineers cost 50–65% less than US senior rates with real-time timezone alignment and no PTO charges billed to the client.
- The offshore rate looks cheaper until you add coordination overhead. An 84% slower change request cycle and 5.5 weeks of annual velocity loss eliminate most of the rate advantage over any meaningful project timeline.
- Budget 15–25% of the original build cost annually for maintenance. Budget for cloud infrastructure, third-party API fees, and post-launch iterations from day one they are not optional.
- Scope ambiguity is the single largest budget risk. Over 52.7% of software projects exceed original budgets by at least 89%. A thorough discovery phase and Solution Roadmap before sprint 1 is the most cost-effective investment in any engagement.
- Time-and-materials with sprint-based delivery outperforms fixed-price for most custom software projects. Fixed-price includes a 15–30% risk premium that T&M avoids provided scope is actively managed.
More cost-effective than hiring in-house, with Nearshore Boost, our nearshore software development service, you can ensure your business stays competitive with an expanded team and a bigger global presence, you can be flexible as you respond to your customers’ needs.
Learn more about our services by booking a free consultation with us today!
