How does software development work? Most non-technical stakeholders understand that it takes time and costs money, but fewer understand why a six-week estimate became twelve weeks, why adding more developers does not always make a project faster, or what a 'sprint' actually produces. This guide explains the process, the team roles, and the decision points that determine whether a project ships on time or compounds into a budget overrun.

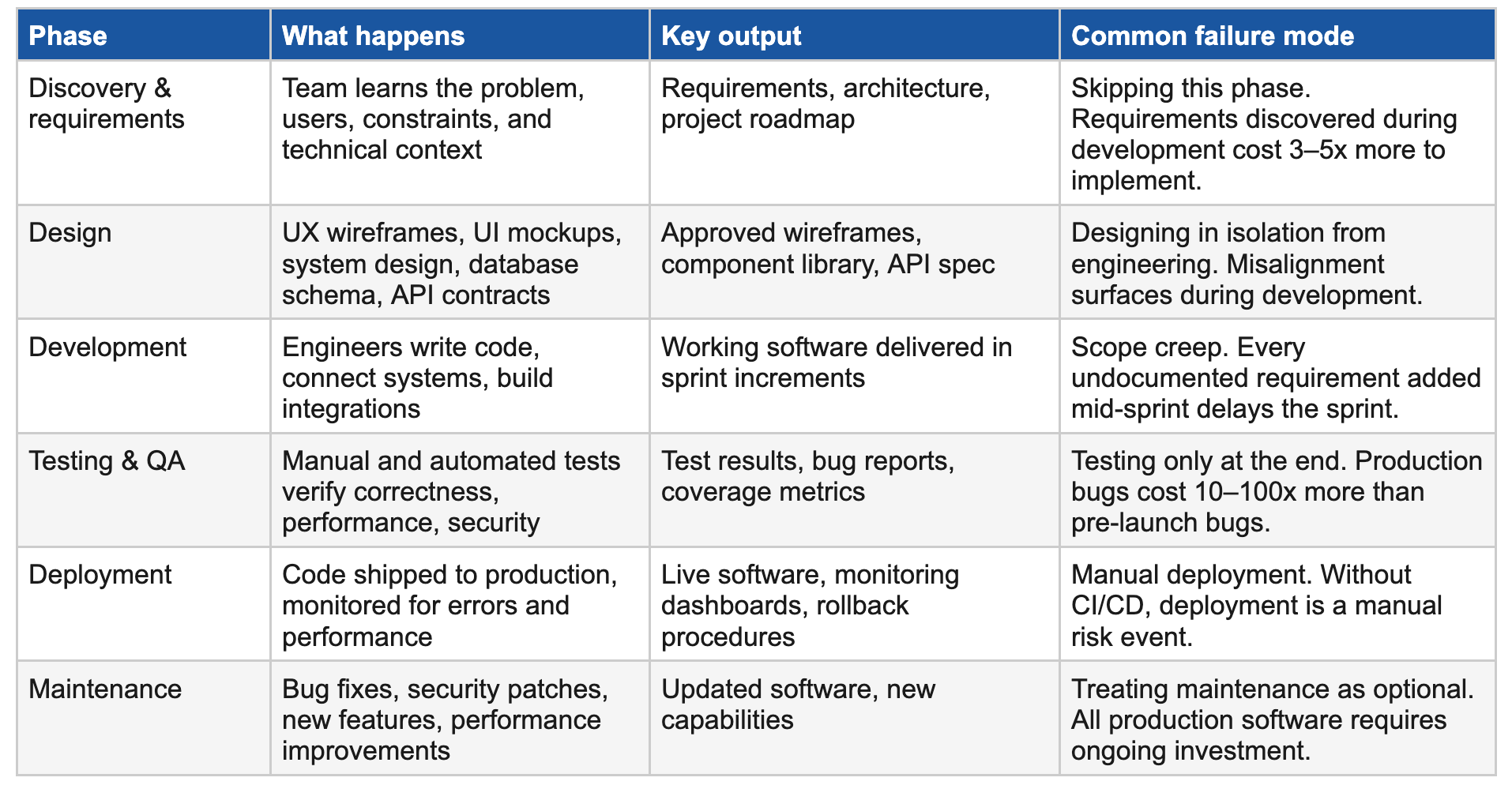

The Software Development Lifecycle
%209.52.06%E2%80%AFp.%E2%80%AFm..png)
Agile vs Waterfall
Waterfall is sequential: complete each phase before starting the next. Appropriate when requirements are fully known before development begins.
Agile is iterative: work in short 2-week sprints, deliver working software at the end of each cycle, and adjust based on what you learn. According to the Standish Group's 2024 CHAOS Report, agile projects are 2.5x more likely to succeed than waterfall projects. Most teams today run Scrum planning, daily standups, demo, retrospective.

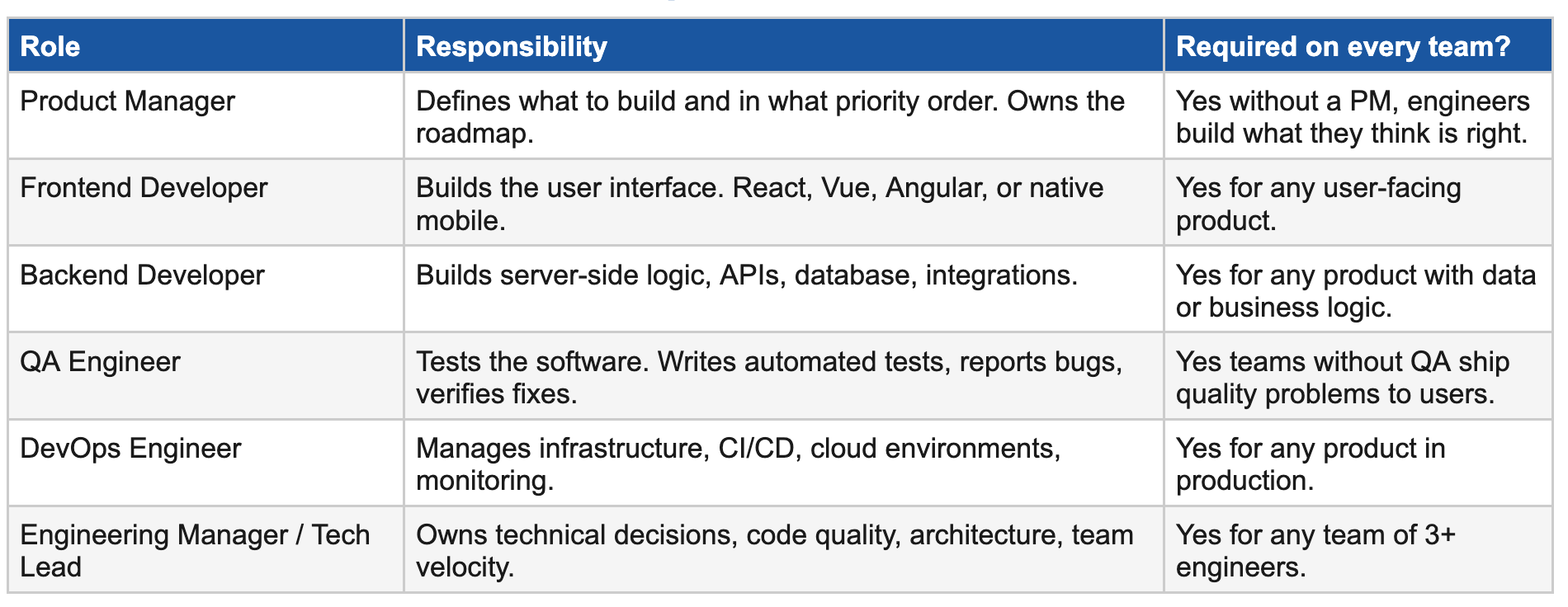

Core Roles in a Software Development Team
%209.53.17%E2%80%AFp.%E2%80%AFm..png)
How Nearshore Staff Augmentation Fits Into the SDLC
Most engineering teams have a permanent core and a variable layer. Staff augmentation through Bluelight's nearshore model adds capacity for specific phases or specific skills without permanently expanding headcount most effective when product demand accelerates faster than US recruiting can keep up, when a specific phase requires skills not present on the core team, or when a defined period of elevated demand (a launch, compliance deadline, major feature) requires temporary expansion.
According to Bluelight's published benchmark data, nearshore LATAM engineers onboard in 7–14 business days and complete change requests 84% faster than offshore alternatives a direct result of timezone alignment enabling real-time participation in every phase of the SDLC.
To see how this works in practice across a full SDLC engagement,explor Bluelight's staff augmentation model.
Common Software Development Methodologies Beyond Scrum
Beyond Scrum, teams use Kanban (continuous flow, best for interrupt-driven work like DevOps), Scrumban (a blend of both), and XP practices like test-driven development and pair programming. The framework matters less than whether it matches your team's actual work pattern a team with unpredictable production incidents needs Kanban's flow control more than Scrum's sprint planning.
How to Estimate a Software Development Project
Single-number estimates "this will take six weeks" fail predictably because they hide the uncertainty a team actually has about unfamiliar code, unclear requirements, and integration risk. Two estimation habits reduce that failure mode without adding much process overhead.
Three-point estimation asks for an optimistic, likely, and pessimistic estimate for each piece of work, then uses a weighted average (commonly (optimistic + 4 x likely + pessimistic) / 6) to produce a single number that already accounts for uncertainty, instead of anchoring on a best-case guess and getting blindsided by the pessimistic case later.
Story points instead of hours estimate relative size and complexity rather than calendar time, which forces the team to separate "how big is this" from "how many hours do I have this week." Velocity points completed per sprint then converts size into a real-world timeline based on the team's actual historical throughput, not a manager's hoped-for pace.
Estimates drift for reasons that have nothing to do with developer skill: unclear acceptance criteria, dependencies on systems the team does not control, and scope added mid-sprint without removing anything else. Tracking why an estimate missed not just that it missed is what makes the next estimate more accurate. For a detailed breakdown of what a project actually costs once scope, team composition, and location are factored in, see the software development cost and hourly rate guide.
Where Software Projects Actually Go Over Budget
Budget overruns rarely come from developers coding too slowly. They come from a small set of recurring causes that show up late enough in the project to be expensive to fix.
- Requirements discovered mid-build. A stakeholder realizes during a sprint demo that the feature needs to handle a case nobody mentioned in discovery reworking half-built code costs far more than addressing it during requirements.
- Third-party integration surprises. An API behaves differently than its documentation suggests, or a vendor's rate limits are lower than expected, and the integration takes three times the estimated effort.
- Security and compliance retrofitted late. Adding authentication, audit logging, or data encryption after the core system is built usually means touching every layer that was built without them in mind.
- Maintenance and support underestimated. Teams budget for building the software and underbudget for the ongoing cost of keeping it running patching dependencies, monitoring, and fixing the inevitable production issues.
None of these are avoidable in an absolute sense, but all four are cheaper to handle when a team plans for them explicitly instead of discovering them mid-project. A discovery phase that explicitly asks about compliance requirements and third-party dependencies up front, and a maintenance budget built into the original estimate rather than added later, closes most of the gap.
Frequently Asked Questions
What is the software development lifecycle?
The SDLC is the sequence of phases a project moves through: discovery and requirements, design, development, testing, deployment, and maintenance. Each phase produces outputs that the next phase depends on.
What is the difference between agile and waterfall?
Waterfall is sequential complete each phase before starting the next. Agile is iterative work in 2-week sprints and deliver working software incrementally. Agile is better for most product development because requirements evolve as stakeholders see working software.
How long does software development take?
A simple MVP takes 6–12 weeks. A mid-size SaaS platform takes 5–10 months. An enterprise platform takes 8–18 months. Timeline is driven by feature scope, integrations, compliance requirements, and team size.
What roles are in a software development team?
A complete team includes Product Manager, frontend developer, backend developer, QA engineer, DevOps engineer, and UI/UX designer. Smaller teams combine roles a full-stack developer handles frontend and backend; a senior engineer acts as both developer and tech lead.
How does nearshore staff augmentation fit into a software development team?
Nearshore staff augmentation adds vetted engineers to your existing team for specific phases or skills without permanent headcount expansion. They report to your technical leads, work your hours, and integrate into your sprint process. Bluelight engineers onboard in 7–14 business days.
Key Takeaways
- The SDLC has six phases discovery, design, development, testing, deployment, maintenance and skipping or rushing any one of them is the most common cause of budget and timeline overruns, not developer speed.
- Agile beats waterfall for most product work because it surfaces requirement changes early, when they are cheap to absorb, instead of at the end, when they are expensive.
- Estimation improves by acknowledging uncertainty (three-point estimation, story points) rather than by trying to force a single confident number out of an inherently uncertain process.
- Nearshore staff augmentation adds capacity at any SDLC phase without the 6-to-12-week US hiring cycle, which matters most when a specific phase not the whole team is the actual bottleneck.
- Budget overruns concentrate in four predictable places: late-discovered requirements, third-party integration surprises, retrofitted security/compliance, and underestimated maintenance all four are cheaper to plan for than to fix mid-project.
